ALCM Is Here: How Much Will Solar Prices Rise — and What Should You Do About It?

Opening hook card — India's ALCM deadline passed June 1 2026 with no blanket extension, raising three key questions for solar buyers: how much will prices rise, who is affected, and what is the right strategy

June 1, 2026 came and went — and so did any hope of a blanket extension. MNRE confirmed in its Office Memorandum of May 25, 2026 that the ALCM mandate is live. Developers who wanted more time had to file project-specific exemption applications through the DCR Portal by June 30, 2026. MNRE has categorically said they won’t accept physical applications — portal or nothing.

So here we are. If you’re evaluating solar right now — whether it’s a rooftop for your factory, an open access project, or a ground-mounted captive plant — ALCM is the new reality you’re working inside. Let’s talk about what it actually means: what will cost more, by how much, who catches a break, and what smart buyers are doing about it.

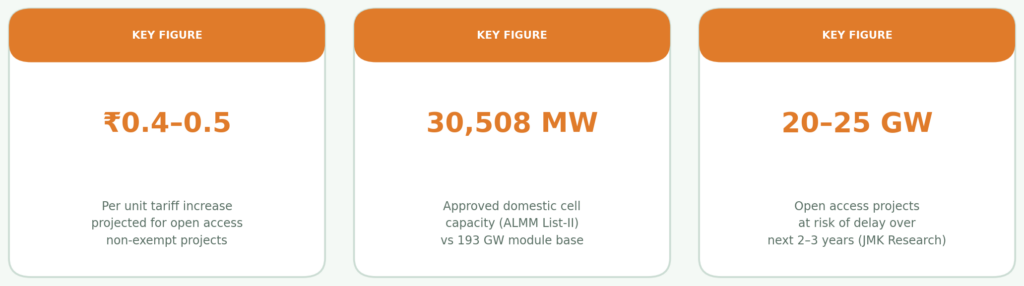

Three key ALCM figures — projected tariff increase of 0.4 to 0.5 rupees per unit, ALMM List-II approved cell capacity of 30508 MW versus 193 GW module base, and 20 to 25 GW open access projects at risk according to JMK Research
Three numbers that frame the ALCM impact. Sources: MNRE ALMM lists (May 2026), JMK Research report (August 2025), Saatvik Green Energy CEO statement.

What Is ALCM — and How Did We Get Here?

ALCM stands for Approved List of Cells and Manufacturers — think of it as ALMM List-II, an extension of India’s existing ALMM framework that now reaches one layer deeper into the supply chain to cover solar cells, not just modules. For years, module manufacturers could import cells from China, assemble them in India, and sell those as “ALMM-compliant.” Technically legal. Clearly not the spirit of the policy. ALCM closes that gap. MNRE signalled this back in December 2024 — the direction was never ambiguous, just the timeline.

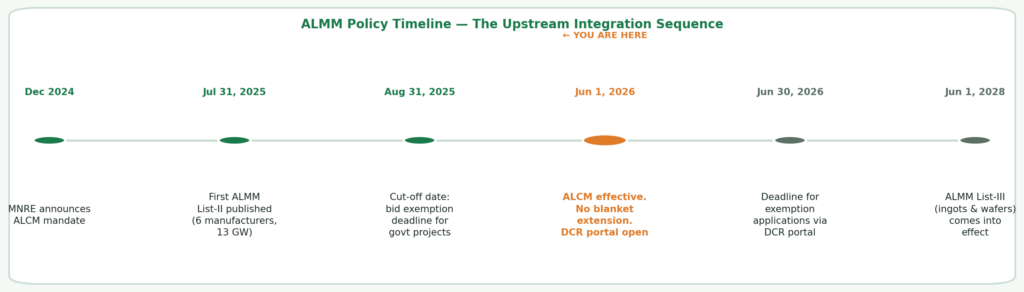

ALCM policy timeline showing six key dates — December 2024 MNRE announcement, July 31 2025 first List-II published, August 31 2025 bid exemption cut-off, June 1 2026 effective date marked as current, June 30 2026 exemption portal deadline, and June 2028 ALMM List-III wafer mandate
The full ALMM upstream integration sequence. ALCM (cells) is the second step. ALMM List-III (ingots and wafers) follows in June 2028. This policy trajectory is not reversing.

The Honest Supply Picture

India’s module manufacturing capacity is genuinely impressive — ALMM List-I is now past 193 GW. But the whole point of ALCM is that those modules now need Indian-made cells. ALMM List-II has been revised seven times since its first publication on July 31, 2025. The latest revision puts total listed cell capacity at 30,508 MW across 13 manufacturers. That’s a 193 GW module industry trying to feed from a roughly 30 GW cell pool.

And it gets tighter. Nameplate capacity isn’t the same as cells you can actually get delivered and certified. Industry consensus puts effective stable TOPCon supply — the technology most large projects actually want — at around 10–12 GW. Cell manufacturing isn’t a fast business: specialised infrastructure, ETP and ZLD systems, 15 to 24 months of setup time. Several factories that were announced won’t come online before 2027. Meanwhile, most of India’s existing cell base is Mono PERC, and the market has largely moved toward TOPCon. The result: DCR-compliant modules are expensive and, in some cases, genuinely hard to get. Certification delays of six to nine months are being projected.

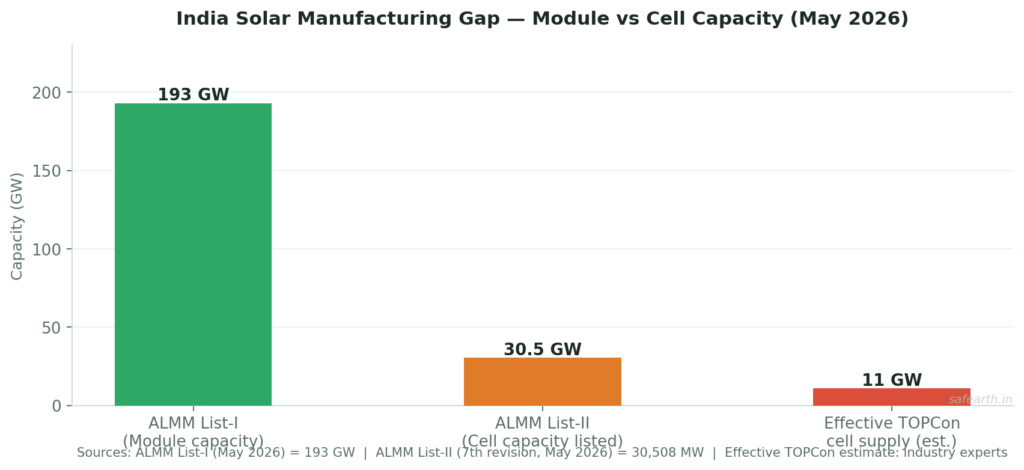

Bar chart showing India solar manufacturing capacity gap as of May 2026 — ALMM List-I module capacity at 193 GW, ALMM List-II approved cell capacity at 30.5 GW, and effective stable TOPCon cell supply estimated at only 11 GW by industry experts
The supply gap driving ALCM cost pressure. 193 GW module industry sourcing cells from ~30 GW approved pool, with effective stable TOPCon supply estimated at 10–12 GW. Sources: MNRE ALMM lists, industry expert estimates.

Okay — So How Much More Are We Talking?

The honest answer: it depends on your project, your state, and when you’re procuring. But here’s what the industry is saying.

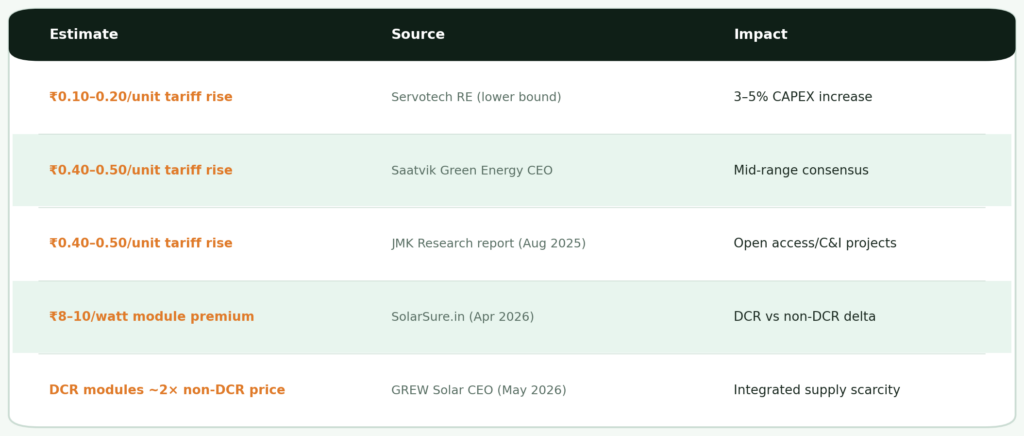

Table of five independent price increase estimates for ALCM impact on solar — Servotech at 0.10 to 0.20 rupees per unit lower bound, Saatvik Green Energy at 0.40 to 0.50 per unit mid-range, JMK Research confirming 0.40 to 0.50 per unit for open access, SolarSure at 8 to 10 rupees per watt DCR premium, GREW Solar CEO noting DCR modules at nearly double non-DCR prices
Five independent estimates of ALCM-driven cost increases. The realistic range for most C&I and open access buyers: CAPEX rises 3–8%, landed cost increases ₹0.20–0.50/unit.

JMK Research estimates the DCR module shortage is likely to hamper 20–25 GW of green open access projects over the next 2–3 years, with project power tariffs increasing by up to ₹0.4–0.5 per unit. At the module level, DCR modules currently carry a ₹8–10 per watt premium over non-DCR. One CEO at a large module company put it plainly — DCR modules are priced at nearly double non-DCR right now.

Who Actually Gets an Exemption?

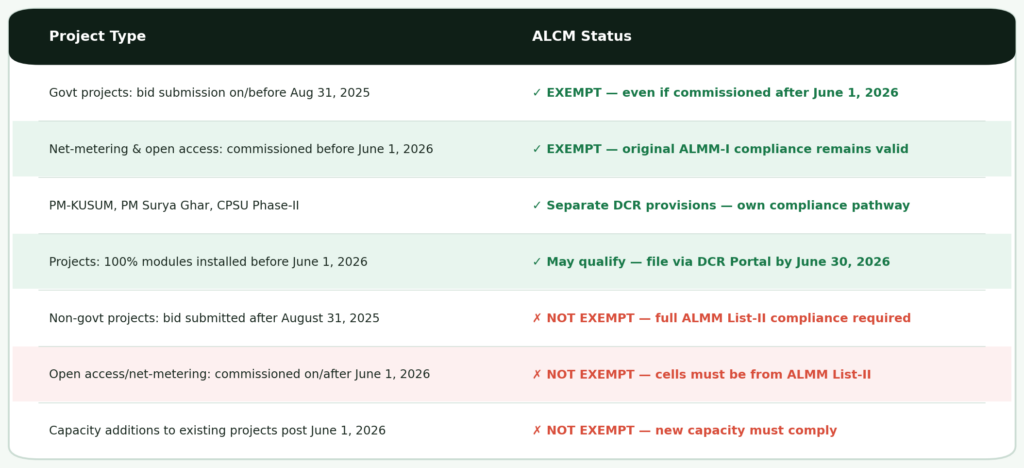

ALCM exemption status table for seven project types — government projects bid before August 31 2025 exempt, net-metering commissioned before June 1 2026 exempt, PM-KUSUM PM Surya Ghar CPSU with own DCR provisions, projects with modules installed before June 1 may file DCR portal, non-government projects bid after August 2025 not exempt, open access commissioned after June 1 not exempt, capacity additions not exempt
ALCM exemption status by project type. The critical dividing line: bid submission on or before August 31, 2025, and commissioning date relative to June 1, 2026. Verify your project’s exact status precisely.

You’re likely exempt if: you’re a government project where bids closed on or before August 31, 2025; your net-metering or open access project was commissioned before June 1, 2026; you’re under PM-KUSUM, PM Surya Ghar, or CPSU Phase-II (which have their own DCR pathways); 100% of your modules were physically installed before June 1, 2026; or your project had CEIG and liaisoning approvals completed before the deadline — subject to filing documentation through the DCR Portal at solardcrportal.nise.res.in by June 30, 2026.

You’re not exempt if: you’re a non-government project where the bid was submitted after August 31, 2025; your open access or net-metering project is commissioning on or after June 1, 2026; or you’re adding capacity to an existing project after June 1, 2026. That last category covers basically the entire active C&I solar pipeline — which is exactly where most commercial and industrial buyers reading this sit. And MNRE has been clear: applications go through the DCR portal only. No physical submissions, no exceptions on process.

This Isn’t Where the Policy Stops

Worth stepping back to see the full picture. In March 2026, MNRE announced ALMM List-III — covering ingots and wafers — with a mandate date of June 1, 2028. So the upstream integration continues: modules first, then cells, then wafers and ingots. If you’re commissioning a project in 2026 meant to run for 25 years, it will be operating under the wafer mandate by 2028. That’s two years away. A DPR that doesn’t account for this is modelling a future that won’t exist.

What Should You Actually Do?

The underlying solar economics are still solid. Even with ALCM pushing costs up, a factory paying ₹10/unit to the grid and generating solar at ₹4/unit all-in is still saving ₹6/unit — compounding for 25 years as grid tariffs rise. A ₹0.40/unit ALCM impact on a ₹9/unit tariff is a 4.4% reduction in absolute saving. Uncomfortable, not catastrophic.

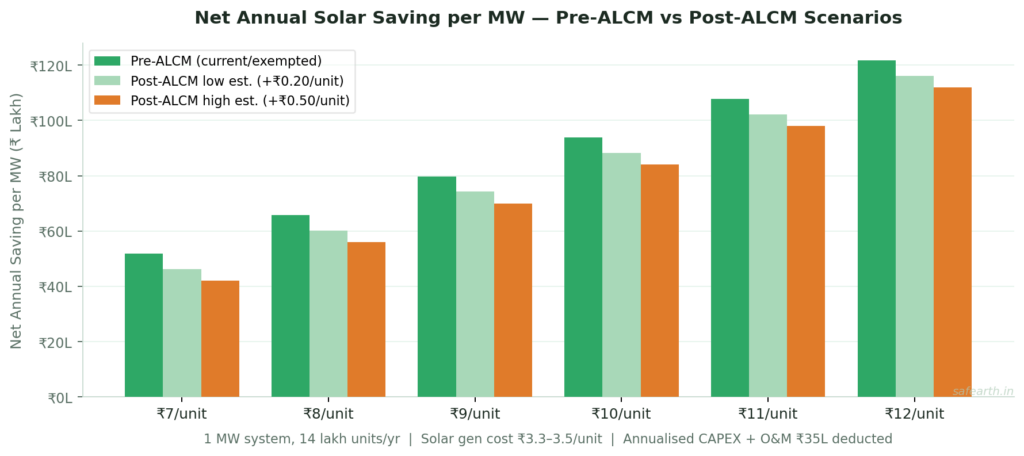

Grouped bar chart comparing net annual solar saving per MW before ALCM versus post-ALCM low estimate of 0.20 rupees per unit increase and high estimate of 0.50 per unit increase across six grid tariff levels from 7 to 12 rupees — showing savings remain substantial in all scenarios
Even at the high-end ₹0.50/unit ALCM impact, net annual savings remain compelling across all tariff levels. The solar investment case is smaller than 18 months ago — it is not broken.
Four strategy cards for C&I solar buyers navigating ALCM — act on rooftop solar before supply tightens, require ALMM List-II compliant EPC supply chain, evaluate PPA as procurement buffer against compliance risk, and model 2028 wafer mandate into DPR now
Four strategic actions for C&I solar buyers in the post-ALCM environment. The buyers who do best move with verified supply chain visibility and model the full upstream integration trajectory before committing.

Move on rooftop solar sooner rather than later. The supply crunch for DCR-compliant modules is going to get tighter before it gets easier. With 20–25 GW of green open access projects competing for the same limited supply, rooftop buyers who move early are ahead of the queue.

Ask your EPC the hard supply chain question. It’s not enough to hear “we use DCR modules.” Ask which specific cell manufacturers on ALMM List-II they’re sourcing from, what their confirmed allocation is, and whether those cells carry valid certification. If they can’t answer clearly, that’s your answer. Explore SafEarth’s commercial rooftop solar advisory to understand what rigorous supply chain verification looks like.

Think seriously about the OPEX/RESCO route. Under an OPEX/RESCO structure, the developer takes on the CAPEX, the module procurement risk, and the ALCM compliance risk. If DCR module prices spike further, that pain lands on their P&L, not yours. You pay a per-unit tariff that’s below your grid rate from day one, with no capital on the table. The trade-off is you don’t build an asset and the long-term returns are lower than CAPEX ownership. For buyers who want cost reduction without procurement exposure right now, that may be worth it. SafEarth’s Capex vs PPA guide walks through exactly when each model makes sense.

Put the 2028 wafer mandate into your financial model. If you’re building a DPR today for a 25-year project, model what happens when List-III lands. It isn’t speculative — MNRE has announced it. A financial model that ignores 2028 is leaving a known risk off the table. Use SafEarth’s industrial solar ROI calculator to stress-test both scenarios.

Stop waiting for a reversal. Developers who held off expecting an extension have already paid for that decision — in delayed savings and higher equipment costs as the DCR premium widened. The policy direction is upstream integration, moving one way only. For open access solar and group captive solar buyers, the economics of acting now versus waiting are meaningfully better today than they will be in six months.

Move on rooftop solar sooner rather than later. The supply crunch for DCR-compliant modules is going to get tighter before it gets easier. With 20–25 GW of green open access projects competing for the same limited supply, rooftop buyers who move early are ahead of the queue.

Ask your EPC the hard supply chain question. It's not enough to hear "we use DCR modules." Ask which specific cell manufacturers on ALMM List-II they're sourcing from, what their confirmed allocation is, and whether those cells carry valid certification. If they can't answer clearly, that's your answer. Explore SafEarth's commercial rooftop solar advisory to understand what rigorous supply chain verification looks like.

Think seriously about the OPEX/RESCO route. Under an OPEX/RESCO structure, the developer takes on the CAPEX, the module procurement risk, and the ALCM compliance risk. If DCR module prices spike further, that pain lands on their P&L, not yours. You pay a per-unit tariff that's below your grid rate from day one, with no capital on the table. The trade-off is you don't build an asset and the long-term returns are lower than CAPEX ownership. For buyers who want cost reduction without procurement exposure right now, that may be worth it. SafEarth's Capex vs PPA guide walks through exactly when each model makes sense.

Put the 2028 wafer mandate into your financial model. If you're building a DPR today for a 25-year project, model what happens when List-III lands. It isn't speculative — MNRE has announced it. A financial model that ignores 2028 is leaving a known risk off the table. Use SafEarth's industrial solar ROI calculator to stress-test both scenarios.

Stop waiting for a reversal. Developers who held off expecting an extension have already paid for that decision — in delayed savings and higher equipment costs as the DCR premium widened. The policy direction is upstream integration, moving one way only. For open access solar and group captive solar buyers, the economics of acting now versus waiting are meaningfully better today than they will be in six months.
The saving is smaller than 18 months ago. At ₹10/unit grid vs ₹4/unit solar all-in, it is still ₹6/unit compounding for 25 years. Move with clean supply chain visibility.

ALCM is going to cost more money. Tariffs on non-exempt projects are heading up ₹0.20–0.50/unit. CAPEX is going up 3–8%. Timelines may slip. None of that kills the case for solar. A factory paying ₹10/unit that can generate at ₹4/unit is still building a 25-year cost advantage — just a slightly smaller one than two years ago. See how SafEarth has delivered solar projects across industrial sectors at SafEarth’s case studies.
